1. Brief Description:
The Post Risk Analysis for Automatic Measuring Cup Placement is a Quality Assurance FMEA report prepared for equipment used in the Cepha Block for powder oral dosage manufacturing. The document evaluates risks associated with equipment design, installation, operation, performance, cleaning, safety, documentation, calibration, utilities, and qualification activities. Its objective is to identify potential failure modes, assess their effects and causes, and rank risks using Severity, Occurrence, and Detection scores to calculate the Risk Priority Number (RPN). Risks are categorized as Critical, Major, Moderate, or Minor, with CAPA required for RPN values above 25. The assessment reviews issues such as inadequate DQ/IQ/OQ documentation, missing reference documents, MOC verification, calibration checks, motor operation, safety features, cleaning, change control, and operating speed. Existing controls, SOPs, trained personnel, and qualification checks are used to reduce risk and confirm the equipment remains capable of supporting product quality and operator safety throughout its intended operational lifecycle.

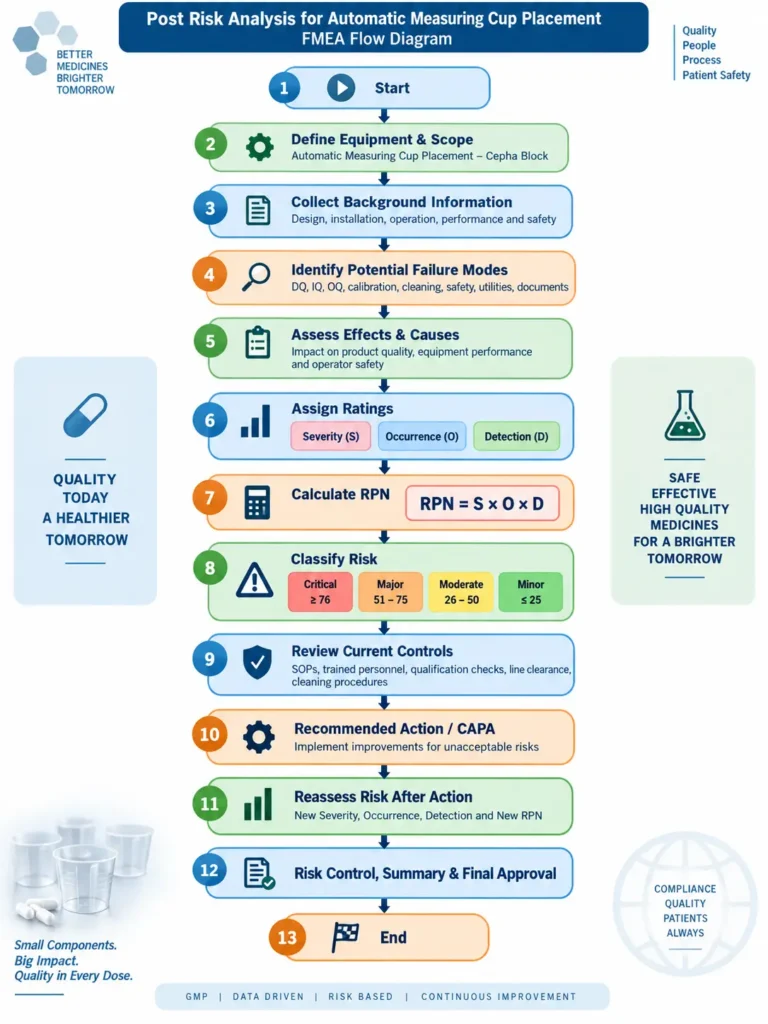

Skip to PDF content2. Flow Diagram:
The flow diagram presents the Post Risk Analysis process for Automatic Measuring Cup Placement using the FMEA methodology. It begins with defining the equipment and assessment scope, followed by collection of background information related to design, installation, operation, performance, and safety. Potential failure modes are then identified and their possible effects and causes are evaluated. Each risk is rated for Severity (S), Occurrence (O), and Detection (D), and the Risk Priority Number (RPN = S × O × D) is calculated. Risks are classified as Critical, Major, Moderate, or Minor according to predefined RPN criteria. Existing controls such as SOPs, qualification checks, training, cleaning, and safety measures are reviewed. Where necessary, CAPA is implemented, followed by residual-risk reassessment, documentation of risk-control measures, preparation of the summary and conclusion, and final approval to confirm that identified risks are adequately controlled.

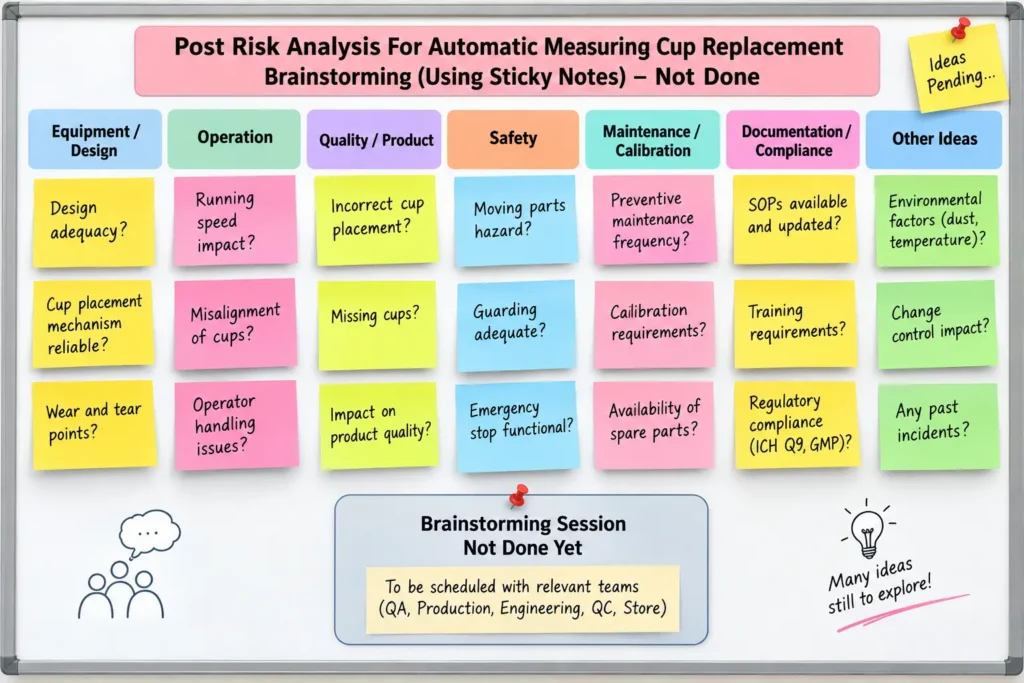

3. Brainstorming:
Post Risk Analysis for Automatic Measuring Cup Replacement – Not Done indicates that the formal FMEA-based evaluation has not yet been completed after implementation or replacement of the measuring cup system. The source document defines the purpose of post-risk assessment as evaluating risks related to the equipment’s design, installation, operation, performance, and safety using the FMEA methodology.

Until the assessment is performed, potential failure modes such as inadequate qualification documents, incorrect cup placement, calibration issues, cleaning deficiencies, safety concerns, operating-speed problems, and equipment-performance failures may not be systematically evaluated. The FMEA should assign Severity, Occurrence, and Detection ratings and calculate the Risk Priority Number (RPN) to determine whether additional controls or CAPA are required. Completion of the post-risk analysis is important to confirm that existing controls are effective and that residual risks to product quality, equipment performance, and operator safety are acceptable.

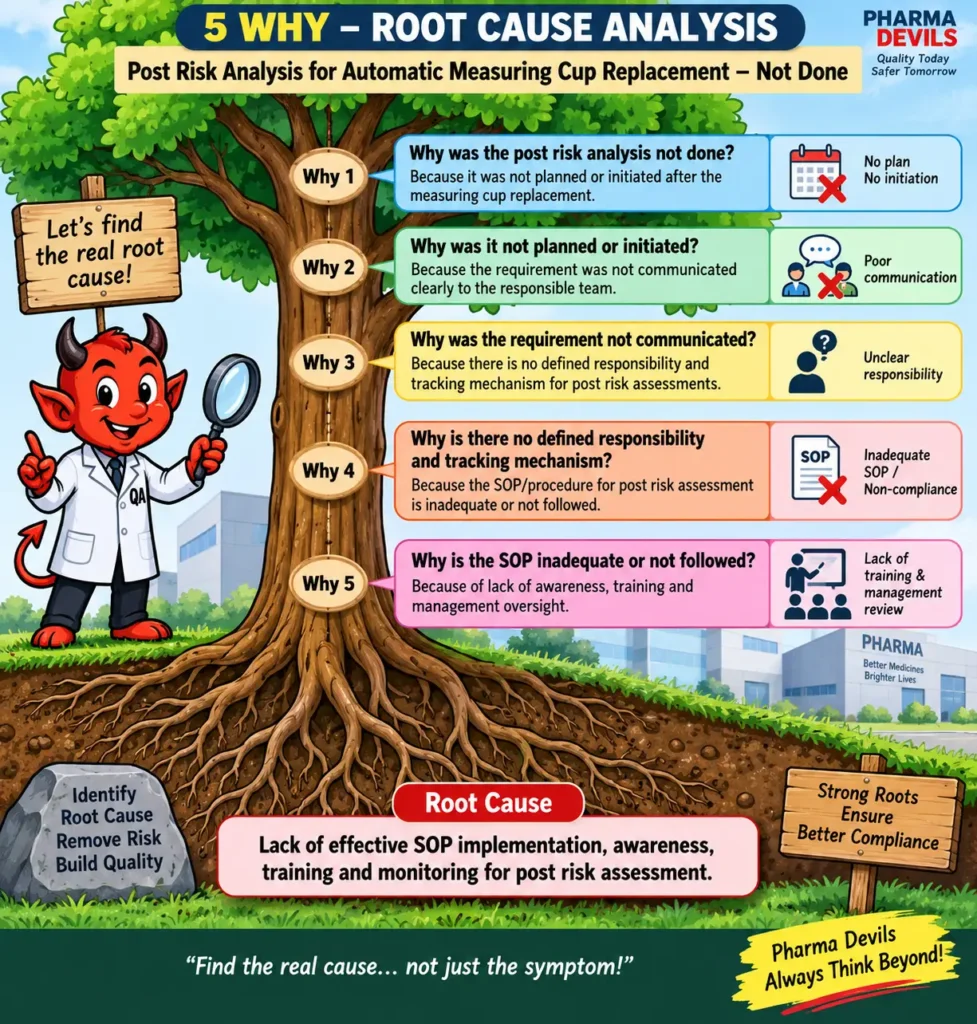

4. 5 Why Analysis:
The 5 Why Analysis for Post Risk Analysis for Automatic Measuring Cup Replacement – Not Done is used to identify the underlying reason why the required post-risk assessment was not completed after equipment replacement. The analysis starts with the immediate problem: the post-risk assessment was not planned or initiated. Further questioning identifies poor communication of the requirement, unclear responsibility for initiating and tracking the assessment, inadequate implementation or follow-up of the applicable SOP, and insufficient awareness, training, and management monitoring. The analysis therefore indicates that the main root cause is a weak system for SOP implementation, responsibility assignment, training, and follow-up of post-risk assessment activities. This is relevant because the source risk-management document requires post-assessment using FMEA for the Automatic Measuring Cup Placement equipment and defines responsibilities involving Quality Assurance, Engineering, Production, Quality Control, and Store. Addressing the root cause can help ensure timely risk reassessment and documented control of residual risks.

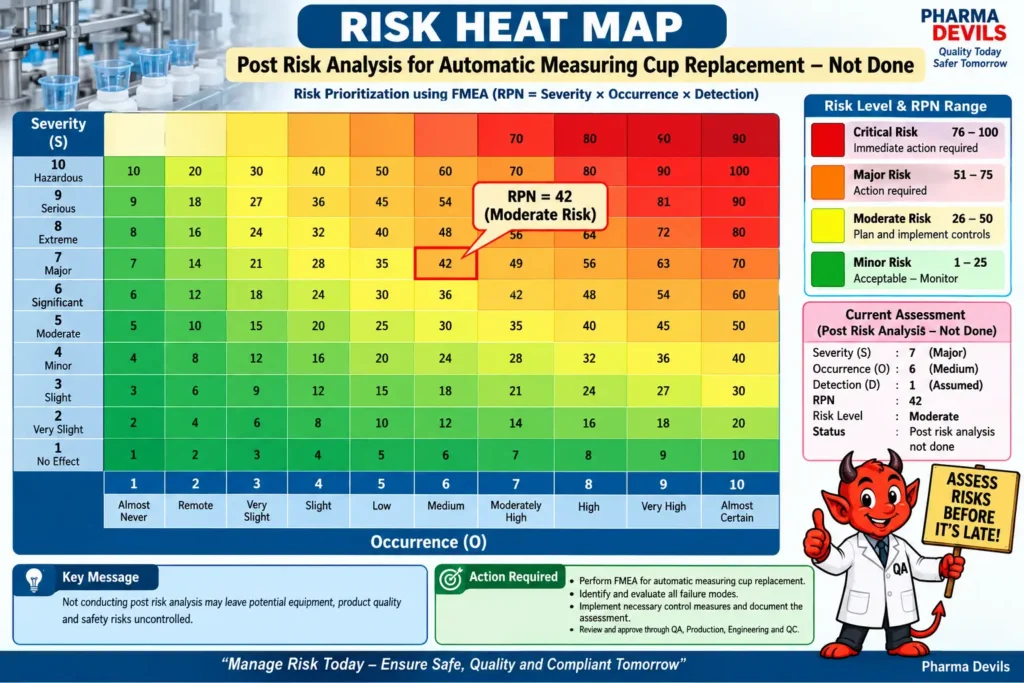

5. Heat Map:
The Heat Map for Post Risk Analysis for Automatic Measuring Cup Replacement – Not Done visually represents the potential risk associated with failure to perform the required post-risk assessment. The diagram uses Severity, Occurrence, and Detection principles from the FMEA methodology to prioritize risk and support decision-making. The example shown highlights a Moderate Risk, indicating that additional control measures and documented assessment should be planned. According to the source document, risks with an RPN of 26–50 are classified as Moderate and require CAPA, while higher RPN values fall into Major or Critical categories. The heat map emphasizes that leaving the post-risk analysis incomplete may allow potential equipment-performance, product-quality, safety, qualification, or compliance risks to remain insufficiently evaluated. The highlighted score in the diagram is illustrative; actual Severity, Occurrence, and Detection ratings should be assigned by the authorized cross-functional team based on documented evidence and existing controls.

Critical Process Parameters (CPP) & Critical Quality Attributes (CQA)
Automatic Vertical Round Bottle Sticker Labelling Machine
| Critical Process Parameters (CPP) | Purpose / Risk if Not Controlled |
|---|---|
| Machine / conveyor speed | Controls synchronization and consistent label application |
| Label dispensing speed | Prevents label stretching, wrinkles, or incorrect placement |
| Bottle spacing / feed rate | Ensures one bottle is presented correctly at the labelling station |
| Label sensor sensitivity | Ensures accurate detection and dispensing of each label |
| Product/bottle sensor sensitivity | Detects bottle presence and initiates label application |
| Label position setting | Maintains specified label location on the bottle |
| Dispensing delay / timing | Synchronizes bottle movement with label release |
| Applicator roller / belt pressure | Ensures proper adhesion without damaging the bottle or label |
| Applicator belt speed | Prevents skewing and supports uniform wrapping |
| Label web tension | Prevents label misfeeding, tearing, or wrinkling |
| Bottle guide / alignment setting | Maintains correct bottle orientation during labelling |
| Coding / printing parameters, where applicable | Ensures batch number, Mfg./Exp. date and other variable data are correctly printed |
| Reject system setting | Removes bottles with missing or unacceptable labels |
| Machine interlock / alarm settings | Prevents operation under abnormal or unsafe conditions |
Critical Quality Attributes
| Critical Quality Attributes (CQA) | Expected Requirement |
|---|---|
| Correct label | Approved label corresponding to the correct product and batch |
| Label presence | Every acceptable bottle shall have the required label |
| Label position | Label applied within the approved positional specification |
| Label alignment | Label should be straight, properly centered and not skewed |
| Label adhesion | Label firmly adhered without lifting or peeling |
| Wrinkle-free application | No unacceptable wrinkles, folds, bubbles or creases |
| Label integrity | No torn, damaged or mutilated labels |
| Printed information accuracy | Batch No., Mfg. Date, Exp. Date, MRP, etc. correct, where applicable |
| Print legibility | Variable and fixed information clear and readable |
| Barcode / 2D code readability | Code correctly printed and scannable, where applicable |
| Product identity | Label information matches the packed product |
| Bottle appearance | Bottle not damaged, scratched or deformed during labelling |
| Rejection effectiveness | Missing, wrongly labelled or defective units reliably rejected |
| Traceability | Label and coding information provides correct batch identification |
Questions & Answers – Post Risk Analysis for Automatic Measuring Cup Replacement
- Q: What is the purpose of the Post Risk Analysis?
A: To assess risks associated with the Automatic Measuring Cup Placement/Replacement equipment after implementation and confirm that risks related to design, installation, operation, performance, and safety are adequately controlled. - Q: Which risk assessment methodology is used?
A: The assessment is performed using FMEA – Failure Mode and Effects Analysis. - Q: Which guideline is referenced for the risk assessment?
A: ICH Q9 – Quality Risk Management is referenced. - Q: What are the three main FMEA rating parameters?
A: Severity, Occurrence, and Detection. - Q: How is the Risk Priority Number calculated?
A: RPN = Severity × Occurrence × Detection. - Q: What RPN is considered Critical?
A: An RPN of 76 or above is classified as Critical and requires CAPA. - Q: What is the Major-risk RPN range?
A: 51 to 75, and CAPA is required. - Q: What is the Moderate-risk RPN range?
A: 26 to 50, and CAPA is required. - Q: What is considered a Minor risk?
A: An RPN of up to 25 is classified as Minor, for which CAPA is stated as not applicable. - Q: Which departments are responsible for the risk assessment?
A: Quality Assurance, Engineering, Production, Quality Control, and Store are identified as responsible functions. - Q: What can happen if Design Qualification documentation is inadequate?
A: The equipment may not function as desired, cGMP requirements may not be met, safety requirements may be unclear, and major components may be missed. - Q: Why is MOC verification important during IQ?
A: Failure to verify material of construction for contact and non-contact parts may create a risk of product contamination. - Q: Why must calibration and instrumentation checks be performed?
A: The document identifies failure to perform instrumentation and calibration checks as a potential failure mode that can affect proper IQ execution. - Q: What risk is associated with improper equipment cleaning?
A: Improper cleaning may result in product contamination. - Q: What risk is associated with inadequate safety features?
A: Inadequate safety provisions for personnel and material may result in accidents. - Q: What happens if major equipment changes are made without documentation?
A: Equipment performance may not be guaranteed and product quality may be affected. - Q: What control is identified for changes to the equipment?
A: A Change Control SOP is identified as the applicable control measure. - Q: Why is post-risk reassessment required after action is taken?
A: The document provides for review of Severity, Occurrence, Detectability, and RPN after actions to confirm the remaining risk. - Q: What should be documented under risk-control measures?
A: Investigation/findings and corrective actions should be documented. - Q: When should the final risk-assessment report be approved?
A: After risks and critical control parameters are identified, control measures are documented, reviewed, and found acceptable.
